Imagine this.

The developer tells you:

“The build is ready.”

You check the release plan.

Production deployment: Tomorrow morning.

Now you look at your testing scope.

You have 15 critical features to test, regression testing pending, API testing still to be done, multiple browsers to check, a few known defects, and test data that isn’t ready yet.

And then you get one more message:

“QA, please complete testing by EOD.”

What would you do?

Work faster?

Skip some testing?

Tell the team, “This is impossible”?

There is actually a better way to handle it.

Unrealistic testing deadlines are a reality in many software projects. Development can run late, requirements can change, or the business may need an urgent release. The important thing is how you respond when there simply isn’t enough time to test everything.

Instead of trying to test everything blindly, step back and ask:

What absolutely needs to be tested before the release?

Then identify the risks, prioritize the important scenarios, communicate what can realistically be covered, and make the remaining risks visible to the stakeholders.

In this article, we’ll look at how to handle unrealistic testing deadlines without compromising your professional judgment or silently accepting unnecessary release risks.

What Is an Unrealistic Testing Deadline?

Simply put, a testing deadline becomes unrealistic when the testing scope is much larger than the time available.

For example, suppose the team gives you 2 days, but based on the scope and complexity, you estimate that proper testing would take around 5 days.

That doesn’t automatically mean the release has to be delayed.

Instead, the first question should be:

“What can we realistically test in these 2 days, and what risks will remain?”

That’s where prioritization becomes important.

Why Do Unrealistic Testing Deadlines Happen?

Unrealistic deadlines can happen for several reasons.

1. Development Was Delayed

There isn’t always one reason.

Sometimes development takes longer than expected. Sometimes a new feature is added at the last minute. And sometimes there is a genuine business reason for releasing quickly.

1. Development Was Delayed

Suppose the original plan was:

Development → 5 days
Testing → 3 days
Release → Day 9

But development takes 8 days instead.

Now QA may have only one day left for testing.

The testing scope hasn’t necessarily become smaller.

The available testing time has.

2. Requirements Change at the Last Minute

You may have experienced this:

“Can we include this feature in tomorrow’s release as well?”

It sounds simple.

But a new feature can mean:

And the deadline usually doesn’t move with the additional scope.

3. Business Wants an Immediate Release

Sometimes the deadline really is important.

It could be because of:

In such situations, trying to test everything perfectly may not be realistic.

The better goal is:

Reduce the most important risks within the time you have.

How to Handle Unrealistic Testing Deadlines

The first thing I’d suggest is: don’t panic.

And don’t immediately respond with:

“This cannot be done.”

Instead, take a few minutes to understand the situation and follow a structured approach.

The 7-Step Approach

  1. Understand the deadline
  2. Identify the testing scope
  3. Estimate the required effort
  4. Prioritize based on risk
  5. Communicate what’s achievable
  6. Document untested areas and risks
  7. Make a risk-based release recommendation

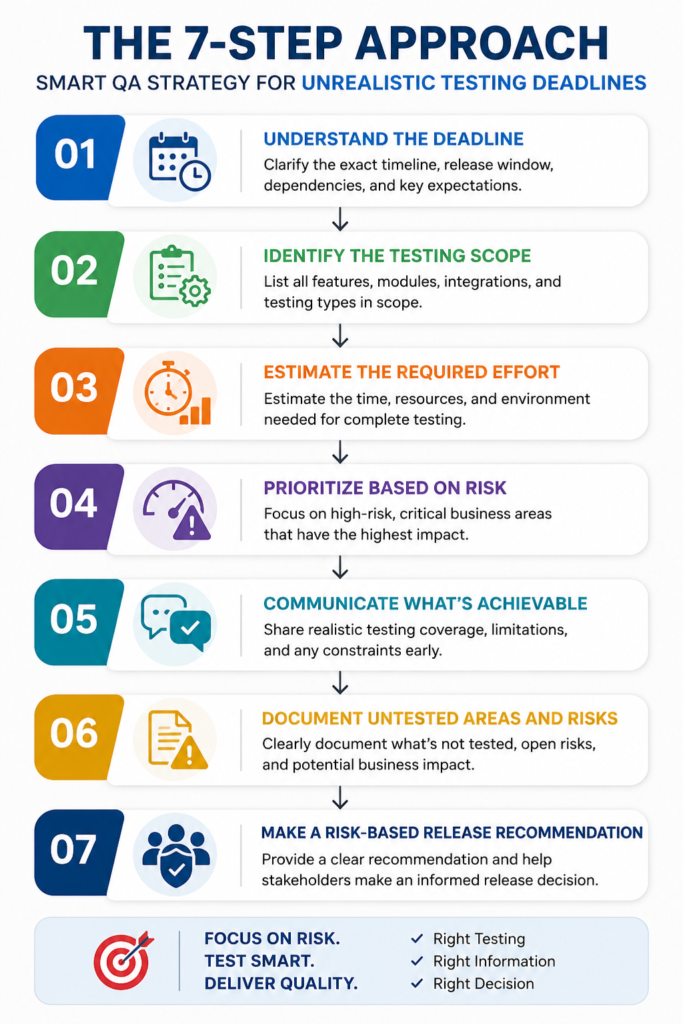

7-step approach to handle unrealistic testing deadlines for QA engineers

Let’s understand each step.

1. Understand the Actual Deadline

Before you start executing test cases, clarify what “complete testing by EOD” actually means.

Ask:

These questions can turn a vague deadline into a much clearer testing plan.

2. Identify the Testing Scope

Don’t look at 100 test cases and think:

“I have to execute all 100 before EOD.”

First divide them according to priority and business impact.

For example:

AreaPriorityEstimated Effort
LoginCritical1 hour
PaymentCritical3 hours
CheckoutCritical2 hours
User ProfileMedium1 hour
ReportsMedium2 hours
UI changesLow1 hour
Full regressionHigh6 hours

If you have only 5 hours, but the estimated effort is 16 hours, the problem is obvious.

Instead of saying:

“We don’t have enough time.”

You can say:

“The current scope needs approximately 16 hours, but we have 5 hours available. I recommend covering payment, checkout, login, and other critical workflows first. Full regression and lower-priority scenarios will remain incomplete.”

That gives the team something they can actually act on.

3. Use Risk-Based Testing

Risk-based testing is particularly valuable when dealing with unrealistic testing deadlines because it helps QA teams focus their limited time on the functionality that presents the greatest business risk.QA professionals can refer to ISTQB Official Website

You cannot test everything equally.

Ask two questions:

Question 1:

How likely is this feature to fail?

Question 2:

What happens if it fails?

High probability + high impact = highest priority

Example

Imagine you’re testing an e-commerce application.

FeatureProbability of FailureBusiness ImpactPriority
LoginMediumHighHigh
PaymentHighCriticalCritical
CheckoutHighCriticalCritical
Product image alignmentMediumLowLow
Profile colorLowLowVery Low
Order cancellationMediumHighHigh

If you have only a few hours, start with:

Payment → Checkout → Order → Login → Critical APIs

Don’t spend the first hour checking button colors.

4. Prioritize Critical Business Flows

When testing time is limited, focus on workflows that can directly affect:

For example, in a banking application:

Login

Account balance

Money transfer

Transaction history

Payment

should generally receive higher attention than cosmetic UI issues.

In an HRMS:

Employee data

Attendance

Leave

Payroll

Role-based access

may be high-risk areas.

The exact priorities should always depend on the application’s business context.

5. Don’t Skip Testing Silently

This is one of the most important rules.

If you don’t have enough time, don’t silently skip test scenarios.

Document what was:

Tested

Partially Tested

Not Tested

This creates transparency.

It also protects the team from assuming that:

“QA completed everything.”

when that wasn’t actually possible.

6. Communicate Risk, Not Just Time

Weak QA communication sounds like:

“I need more time.”

Better communication sounds like:

“The current scope requires approximately 12 hours, but only 5 hours are available. I can complete critical business-flow testing within the available window, but full regression and cross-browser testing will remain incomplete.”

Even better:

“If we release after critical-flow testing only, the remaining risks are regression defects and browser-specific issues. I recommend either extending the testing window or reducing the release scope.”

This changes the conversation from:

QA needs more time

to:

The release has known risks.

That’s a much more professional approach.

7. Discuss Trade-Offs With Stakeholders

QA shouldn’t make business decisions alone.

If testing time is insufficient, present options.

For example:

Option A — Extend Testing

Add one more day for QA.

Benefit: More coverage
Risk: Release delayed

Option B — Reduce Scope

Release only critical features.

Benefit: Better testing coverage for important functionality
Risk: Some features move to a later release

Option C — Release With Known Risk

Test critical flows and release.

Benefit: Meets business deadline
Risk: Untested areas may contain defects

Option D — Phased Release

Release to a smaller group first.

Benefit: Reduced exposure
Risk: Additional release management required

Now stakeholders can make an informed decision.

A QA Engineer Should Not Say “YES” or “NO” Too Quickly

Suppose someone asks:

“Can we release tomorrow?”

Don’t immediately answer:

“Yes.”

And don’t immediately answer:

“No.”

Instead, explain:

Then provide your recommendation.

For example:

“Critical user journeys have passed, and no Sev-1 or Sev-2 defects are currently open. However, full regression and Safari testing are incomplete. Based on the current risk profile, I recommend release only if the business accepts these residual risks.”

That’s risk-based QA thinking.

How to Prioritize Test Cases Under Time Pressure

A simple prioritization model can help.

Priority 1 — Critical

Test first.

Examples:

Priority 2 — High

Test next.

Examples:

Priority 3 — Medium

Test if time permits.

Examples:

Priority 4 — Low

Test last.

Examples:

Use the “Must Test vs Nice to Test” Approach

When the deadline is extremely tight, divide your test scope into two categories.

Must Test

These scenarios could cause serious business impact if they fail.

Nice to Test

These scenarios are useful but less risky.

For example:

Must Test

Nice to Test

This makes prioritization easier.

What If the Manager Says: “Just Test Everything Quickly”?

This happens.

Don’t respond:

“That’s impossible.”

Instead, respond professionally.

You can say:

“I can prioritize the critical workflows and complete those within the available timeline. However, testing the complete scope would require additional time. If we proceed with the current deadline, I’ll document the areas that could not be fully validated and the associated release risks.”

This is assertive without being confrontational.

What If Your Manager Keeps Pushing?

Sometimes the deadline remains unrealistic even after you communicate the risks.

In that situation:

5 steps to handle unrealistic testing deadlines as a QA engineer
Five practical steps for QA engineers to manage unrealistic testing deadlines professionally.

Remember:

QA provides quality information and risk visibility. The final business release decision may belong to the appropriate product/business stakeholders.

Your job is not to artificially declare the product “safe” just because the deadline is approaching.

How to Handle an Unrealistic Deadline Without Burning Out

Testing under pressure can quickly become exhausting.

Avoid trying to compensate for unrealistic planning by continuously working excessive hours.

Instead:

Prioritize

Focus on high-risk areas.

Communicate

Raise risks early.

Collaborate

Work with developers and product owners.

Automate Repetitive Checks

If you have an existing automation suite, use it for suitable regression checks.

Reuse Test Data

Don’t waste time creating the same data repeatedly.

Parallelize

Where practical:

Tester A → Payment

Tester B → User Management

Tester C → API

Tester D → Regression

Track Coverage

Use a simple checklist so nothing critical is accidentally forgotten.

Automation Can Help — But It Is Not a Magic Solution

When deadlines are tight, people sometimes say:

“Just automate it.”

Automation can help, but automation is not an instant solution.

If a feature has never been automated, writing stable automation scripts may take longer than executing a small number of manual tests.

Use automation where:

For example:

A stable login regression suite can be executed automatically.

But a brand-new feature that changed two hours ago may still require exploratory manual testing.

The right question is:

“What testing approach gives us the highest risk coverage within the available time?”

Exploratory Testing Under Tight Deadlines

Exploratory testing can be extremely useful when time is limited.

Instead of executing every detailed test case line by line, use your product knowledge to explore high-risk areas.

For example:

Test a payment workflow by intentionally trying:

This can uncover serious defects quickly.

Example: One-Day Testing Deadline

Suppose you receive a new build at:

10:00 AM

Release is:

Tomorrow at 10:00 AM

You have approximately one working day.

The scope includes:

You obviously cannot provide equal coverage everywhere.

10:00–11:00

Smoke testing

11:00–2:00

Critical business workflows

2:00–4:00

High-risk regression

Focus on areas impacted by the new changes.

4:00–5:00

Negative testing

Test major failure scenarios.

5:00–6:00

Defect retesting

Validate fixed critical defects.

6:00–7:00

Final risk assessment

Document:

The exact schedule will vary by project, but the principle remains:

Prioritize risk instead of attempting unrealistic 100% coverage.
